Skip to main content
Back to Cases
Bildex GruppProject cost control

Project costs from Merit, checked against the estimate every morning.

Book a 30-minute call

Proof at a glance

Projects in the daily run
13
Merit refresh
06:00
Cost categories per project
6
How to read this

The figures describe the system in September 2026, when 13 projects were in the daily 06:00 Merit run (Tallinn time). The screenshots use test data, so none of the company's own figures are shown.

What it looks like

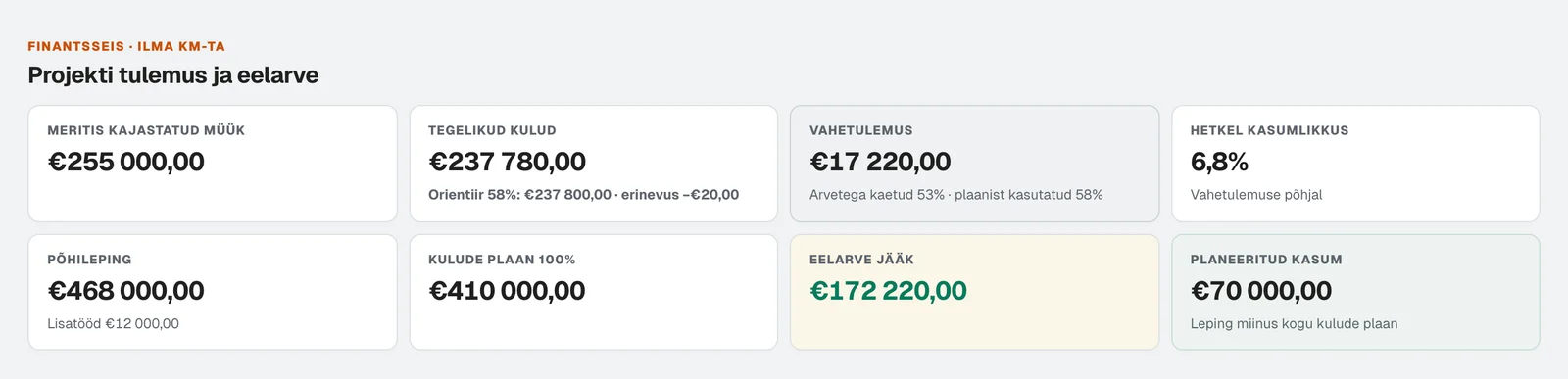

Result and budget for one project
Result and budget cards for one project: sales booked in Merit, actual cost, interim result, current margin, main contract, cost plan, budget left and planned profit. Test data.

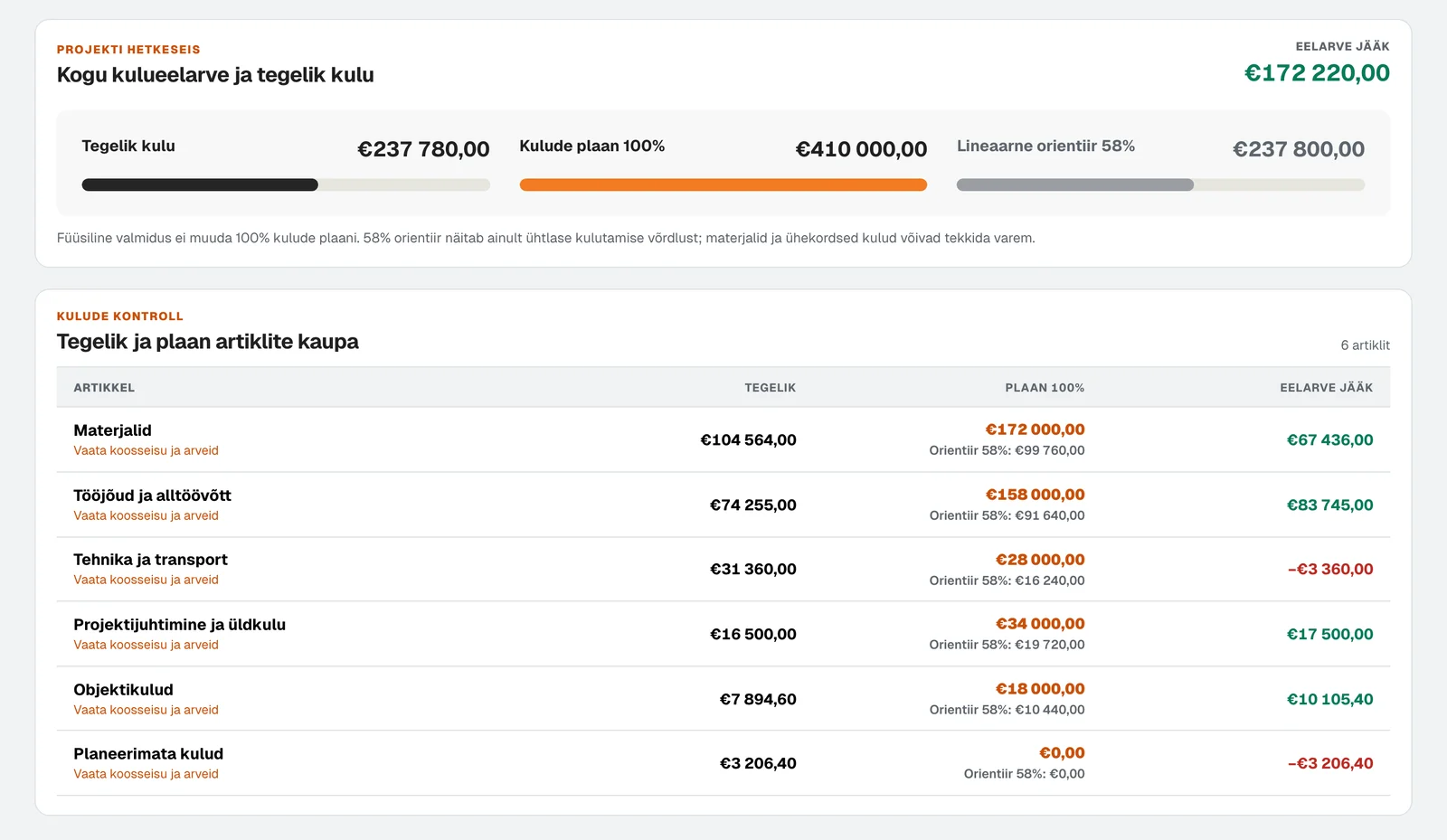

Actual cost against the plan, by category
Actual cost, the full cost plan and a straight-line reference at 58% progress, then a table of six cost categories with actual cost, plan and budget left. Test data.

The real dashboard, shown with test data. None of the company's own figures appear here.

The Context

Bildex Grupp is an Estonian construction contractor running several building projects at the same time. Every project starts from an estimate that was priced and offered to the customer. Sales and purchase invoices are booked in Merit, the company's accounting software.

Why project costs were hard to see

The estimate and the costs sat in different places.

Estimates were kept in Excel and actual costs in Merit, so nobody saw the two side by side.

A project report had to be built by hand.

To see where a project stood, someone pulled the costs out and put a report together. The owner's first request was reporting that comes straight from Merit.

Access had to follow responsibility.

The owner needed to see every project. Each project manager should see only their own.

A dashboard that checks Merit against the estimate

Each project's estimate is loaded once and becomes its cost plan. Every morning at 06:00 a scheduled job reads the project's sales and costs from Merit with read-only access, and the dashboard compares them with the plan category by category, with the invoices behind each category one click away.

What we built

  1. The estimate is loaded once and becomes the project's cost plan.

  2. Sales and costs are read from Merit every morning at 06:00. Nothing is written back.

  3. Actual cost is set against the plan category by category, with the budget left in each. Costs the estimate didn't foresee get their own line.

  4. Each cost category opens the Merit invoices booked to it.

  5. The owner sees every project; a project manager sees only their own.

How it works

  • Merit API with read-only access

  • A scheduled run every morning at 06:00 (Tallinn time)

  • Supabase database; everyone signs in with their own account

  • Each estimate stored as an unchanged version

What changed

Cost against the estimate, every morning.

13 projects were in the daily Merit run in September 2026, so nobody has to build a report to see where a project stands.

Progress and cost in one place.

The budget left in each category is visible while the work is still going on.

Every cost can be traced.

A cost category opens the invoices booked to it, so a question about a cost is answered in the dashboard itself.

The service behind this project

Revenue Visibility

The Workflow Architecture

  • Estimate
    Accepted plan
  • Merit
    Sales · costs
  • Daily refresh
    Schedule · 06:00
  • Cost dashboard
    Plan vs actual
  • Owner
    All projects
  • Managers
    Own projects

*Simplified visualization of the actual solution delivered.

Next step

A similar system for your company starts with a free 30-minute call.

We look at one job that takes too much time right now, and I tell you whether it is worth fixing.

You'll talk with me, Artur Makarov.No sales team and no hand-offs in between.
